(1)

INTEGRATED SCHEDULING OF PRODUCTION AND

LOGISTICS OPERATIONS OF A MULTI-PLANT

MANUFACTURER SERVING A SINGLE CUSTOMER AREA

A THESIS

SUBMITTED TO THE DEPARTMENT OF INDUSTRIAL ENGINEERING

AND THE INSTITUTE OF ENGINEERING AND SCIENCE

OF BILKENT UNIVERSITY

IN PARTIAL FULFILLMENT OF THE REQUIREMENTS

FOR THE DEGREE OF

MASTER OF SCIENCE

By Merve Çelen

(2)

I certify that I have read this thesis and that in my opinion it is fully adequate, in scope and in quality, as a thesis for the degree of Master of Science.

___________________________________ Asst. Prof. Dr. Mehmet Rüştü Taner (Advisor)

I certify that I have read this thesis and that in my opinion it is fully adequate, in scope and in quality, as a thesis for the degree of Master of Science.

______________________________________ Assoc. Prof. Dr. Oya Ekin Karaşan

I certify that I have read this thesis and that in my opinion it is fully adequate, in scope and in quality, as a thesis for the degree of Master of Science.

______________________________________ Asst. Prof. Dr. Sedef Meral

Approved for the Institute of Engineering and Science ____________________________________

Prof. Dr. Mehmet Baray

(3)

ABSTRACT

INTEGRATED SCHEDULING OF PRODUCTION AND LOGISTICS

OPERATIONS OF A MULTI-PLANT MANUFACTURER SERVING A

SINGLE CUSTOMER AREA

Merve Çelen

M.S. in Industrial Engineering

Supervisor: Asst. Prof. Dr. Mehmet Rüştü Taner July, 2009

Increasing market competition forces manufacturers to continuously reduce their leadtimes by minimizing the total time spent in both production and distribution. Some studies in the relevant literature indicate that scheduling production and logistics operations in a coordinated manner leads to improved results. This thesis studies the problem of scheduling production and distribution operations of a manufacturer serving a single customer area from multiple identical production plants dispersed at different geographical locations. The products are transported to the customer area by a single capacitated truck. The setting is inspired by the operations of a leading soft drink manufacturer, and the objective is set in line with their needs as the minimization of the total completion time of the jobs. The completion time of a job is defined as the time it reaches at the customer area. We consider both this general problem and four special cases motivated by common practical applications. We prove that both the main problem and three of its special cases are NP-hard at least in the ordinary sense. We develop mixed integer programming (MIP) models for all these problems and propose a pseudo-polynomial dynamic programming mechanism for the remaining special case. Since the MIP models are able to provide optimal solutions only for small instances in a reasonable amount of time, heuristics are also proposed to solve larger instances. Fast lower bounds are developed to facilitate the performance assessment of these heuristics in medium and large instances. Evidence from extensive computational experimentation suggests that the proposed heuristics are both efficient and effective.

(4)

ÖZET

TEK MÜŞTERİ BÖLGESİNE HİZMET VEREN ÇOK TESİSLİ BİR

İMALATÇININ ÜRETİM ÇİZELGELEME VE LOJİSTİK

FAALİYETLERİNİN BÜTÜNLEŞİK PLANLAMASI

Merve Çelen

Endüstri Mühendisliği, Yüksek Lisans Tez Yöneticisi: Yrd. Doç. Dr. Mehmet Rüştü Taner

Temmuz, 2009

Yükselen pazar rekabeti imalatçıları üretim ve dağıtımda geçen toplam süreyi en küçülterek tedarik sürelerini sürekli olarak azaltmaya zorlamaktadır. İlgili literatürdeki bazı çalışmalar üretim ve dağıtım işlemlerinin bağlantılı bir şekilde çizelgelenmesinin daha iyi sonuçlar verdiğini göstermektedir. Bu tezde farklı coğrafik yerseçimlerindeki özdeş tesislerden tek müşteri bölgesine hizmet veren bir imalatçının üretim ve dağıtım işlemlerinin çizelgelenmesi çalışılmaktadır. Ürünler müşteri bölgesine taşıma kapasitesi belirli bir araç tarafından taşınmaktadır. Problemin tanımı ileri gelen bir alkolsüz içecek imalatçısının çalışmalarından esinlenilmiş ve amaç fonksiyonu onların ihtiyaçlarıyla uyumlu olacak şekilde işlerin bitiş zamanlarının toplamının en küçültülmesi olarak belirlenmiştir. Bir işin bitiş zamanı o işin müşteri bölgesine ulaştığı zaman olarak tanımlanmıştır. Hem genel problem hem de onun pratik uygulamalarda sıklıkla karşılaşılan dört özel durumu ele alınmıştır. Hem esas problemin hem de onun üç özel durumunun NP-zor olduğu kanıtlanmıştır. Tüm bu problemler için karışık tamsayılı programlama (KTP) modelleri geliştirilmiş ve geri kalan özel durum için sözde-polinom bir dinamik programlama mekanizması önerilmiştir. KTP modelleri eniyi sonuçları makul sürelerde sadece küçük örnekler için verebildiğinden büyük örnekleri çözebilmek için sezgisel yöntemler önerilmiştir. Sezgisel yöntemlerin orta ve büyük

(5)

geliştirilmiştir. Yapılan kapsamlı deneyler önerilen sezgisel yöntemlerin verimli ve etkili olduğunu göstermiştir.

Anahtar sözcükler: Çok tesisli çizelgeleme, dağıtım, karmaşıklık, tamsayı programlama,

(6)
(7)

Acknowledgement

First, I would like to express profound gratitude to my advisor, Asst. Prof. Dr. Mehmet Rüştü Taner, for sharing his experience and knowledge with me. I would like to thank him especially for tolerating me when I was upset and nervous.

I am also grateful to Assoc. Prof. Dr. Oya Ekin Karaşan and Asst. Prof. Dr. Sedef Meral for accepting to read and review this thesis and for their invaluable suggestions.

I am as ever, especially indebted to my family, Tülün, Ender and Elif Çelen, for their endless love and support. Everyday on the phone they tried to calm me down and motivate me for hours. Whenever I had a break down, their motivations made me continue. Even when we were at different continents their love was always with me and I would not be able to finish this thesis without them.

I want to thank my roommates Hande Koçak and Çiğdem Ataseven for sharing the life with me for two years.

My sincere thanks go to my friends Bora Karaoğlu, Büşra Çelikkaya, Hayrettin Gürkök, Tuncer Erdoğan, Adnan Tula, Utku Guruşçu, İhsan Yanıkoğlu, Safa Onur Bingöl, Emre Uzun, Hatice Çalık, Sıtkı Gülten, Serdar Yıldız, İpek Şener, Sezgin Küçükçoban and Erkin Bahçeci.

(8)

Finally, I would like to express my special thanks to TÜBİTAK for the scholarship provided throughout this thesis study.

(9)

TABLE OF CONTENTS

Chapter 1: INTRODUCTION ...1

Chapter 2: LITERATURE REVIEW ...4

2.1. Studies with Different Fleet Types...4

2.2. Studies with Different Machine Configuration and Customer Area Properties...7

2.2.1. Single Machine and Single Customer Area...8

2.2.2. Single Machine and Multiple Customer Areas...12

2.2.3. Multiple Machines and Single Customer Area...14

2.2.4. Multiple Machines and Multiple Customer Areas ...17

Chapter 3: PROBLEM DESCRIPTION AND NOTATION ...21

3.1. Sample Problem...25

Chapter 4: METHODOLOGY ...28

4.1. Job Assignments Given Problem...29

4.1.1. Plants at Equal Distances...29

4.1.2. Plants at Different Distances ...31

4.2. Fully Loaded Trips Problem...33

4.2.1. NP-Hardness Proofs for the Fully Loaded Trips Problem and Its Special Case Last Trip Partial Problem ...34

4.2.2. Last Trip Partial Problem ...37

4.2.2.1. Exact Solution Method ...38

4.2.2.2. Heuristic Methods ...41

4.2.2.3. Lower Bound ...48

(10)

4.2.5. Lower Bounds for Fully Loaded Trips Problem ...55

4.3. General Problem...59

4.3.1. NP-Hardness Proofs for the General Problem and the Problem with No Wait Constraint ...60

4.3.2. The Problem with No Wait Constraint...62

4.3.2.1. Exact Solution Method ...62

4.3.2.2. Heuristic Methods ...65

4.3.2.3. Lower Bound ...68

4.3.3. Exact Solution Method for the General Problem ...72

4.3.4. Heuristic Methods for the General Problem...74

4.3.5. Lower Bound for the General Problem ...76

Chapter 5: EXPERIMENTAL DESIGN AND NUMERICAL RESULTS ...78

5.1. Experimental Design ...78

5.2. Numerical Results ...81

5.2.1. Numerical Results and Discussions for Last Trip Partial Problem ...82

5.2.2. Numerical Results and Discussions for Fully Loaded Trips Problem...93

5.2.3. Numerical Results and Discussions for the Problem with No Wait Constraint ...104

5.2.4. Numerical Results and Discussions for the General Problem...115

5.2.5. Comparison of Proposed Methods ...123

Chapter 6: CONCLUSION...126

BIBLIOGRAPHY ...129

APPENDIX ...133

A. Pseudocodes of the Lower Bound Generation Methods...133

(11)

A.2. Lower Bound 3 ...134

A.3. Lower Bound 5 ...136

B. Pseudocodes of the the Proposed Heuristics...138

B.1. Heuristic 1 (LPH1)...138 B.2. Heuristic 2 (LPH2)...140 B.3. Heuristic 3 (FTH1)...143 B.4. Heuristic 4 (FTH2)...147 B.5. Heuristic 5 (NWH1)...153 B.6. Heuristic 6 (NWH2)...155 B.7. Heuristic 7 (GH) ...157

C. Numerical Results for Last Trip Partial Problem ...161

D. Numerical Results for Fully Loaded Trips Problem ...210

E. Numerical Results for No Wait Problem ...259

(12)

LIST OF FIGURES

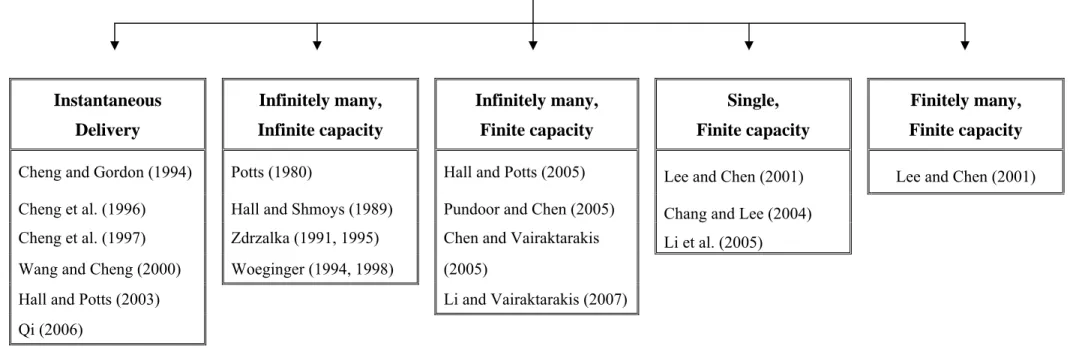

2.1. Literature classification for fleet type... 19

2.2. Literature classification for machine/plant configuration and customer area properties . 20 3.1. A representation of plant locations and distances to the customer area ... 22

3.2. Gantt chart for the optimal solution of sample problem with 10 jobs and 3 plants... 27

5.1. Numerical results for Heuristic 1 for n=25, 40,55 where pj

[ ]

1,11 ...83

5.2. Numerical results for Heuristic 2 for n=25, 40,55 where pj

[ ]

1,11 ...83

5.3. Numerical results for Heuristic 1 for n=10 where pj

[

5,15

]

...85

5.4. Numerical results for Heuristic 2 for n=10 where pj

[

5,15

]

...85

5.5. Numerical results for Heuristic 1 for n=25, 40,55 where pj

[

5,15

]

...86

5.6. Numerical results for Heuristic 2 for n=25, 40,55 where pj

[

5,15

]

...87

5.7. Numerical results for Heuristic 1 for n=10 where pj

[

25,35

]

...88

5.8. Numerical results for Heuristic 2 for n=10 where pj

[

25,35

]

...88

5.9. Numerical results for Heuristic 1 for n=25, 40,55 where pj

[

25,35

]

...89

5.10. Numerical results for Heuristic 2 for n=25, 40,55 where pj

[

25,35

]

...89

5.11. Numerical results for Heuristic 1 for n=10 where pj

[

1,35

]

...91

5.12. Numerical results for Heuristic 2 for n=10 where pj

[

1,35

]

...92

5.13. Numerical results for Heuristic 1 for n=25, 40,55 where pj

[

1,35

]

...92

5.14. Numerical results for Heuristic 2 for n=25, 40,55 where pj

[

1,35

]

...93

(13)

5.16. Numerical results for Heuristic 3 for n=25, 40,55 where pj

[ ]

1,11 ...95

5.17. Numerical results for Heuristic 4 for n=25, 40,55 where pj

[ ]

1,11 ...96

5.18. Numerical results for Heuristic 3 for n=10 where pj

[

5,15

]

...97

5.19. Numerical results for Heuristic 4 for n=10 where pj

[

5,15

]

...97

5.20. Numerical results for Heuristic 3 for n=25, 40,55 where pj

[

5,15

]

...98

5.21. Numerical results for Heuristic 4 for n=25, 40,55 where pj

[

5,15

]

...98

5.22. Numerical results for Heuristic 3 for n=10 where pj

[

25,35

]

...99

5.23. Numerical results for Heuristic 4 for n=10 where pj

[

25,35

]

...100

5.24. Numerical results for Heuristic 3 for n=25, 40,55 where pj

[

25,35

]

...100

5.25. Numerical results for Heuristic 4 for n=25, 40,55 where pj

[

25,35

]

...101

5.26. Numerical results for Heuristic 3 for n=10 where pj

[

1,35

]

...102

5.27. Numerical results for Heuristic 4 for n=10 where pj

[

1,35

]

...103

5.28. Numerical results for Heuristic 3 for n=25, 40,55 where pj

[

1,35

]

...103

5.29. Numerical results for Heuristic 4 for n=25, 40,55 where pj

[

1,35

]

...104

5.30. Numerical results for Heuristic 5 for n=10 where pj

[ ]

1,11 ...105

5.31. Numerical results for Heuristic 5 for n=25, 40,55 where pj

[ ]

1,11 ...106

5.32. Numerical results for Heuristic 5 for n=10 where pj

[

5,15

]

...107

5.33. Numerical results for Heuristic 5 for n=25, 40,55 where pj

[

5,15

]

...108

(14)

5.36. Numerical results for Heuristic 6 for n=25, 40,55 where pj

[

25,35

]

...112

5.37. Numerical results for Heuristic 5 for n=10 where pj

[

1,35

]

...113

5.38. Numerical results for Heuristic 6 for n=10 where pj

[

1,35

]

...113

5.39. Numerical results for Heuristic 5 for n=25, 40,55 where pj

[

1,35

]

...114

5.40. Numerical results for Heuristic 6 for n=25, 40,55 where pj

[

1,35

]

...114

5.41. Numerical results for Heuristic 7 for n=10 where pj

[ ]

1,11 ...116

5.42. Numerical results for Heuristic 7 for n=25, 40,55 where pj

[ ]

1,11 ...117

5.43. Numerical results for Heuristic 7 for n=10 where pj

[

5,15

]

...118

5.44. Numerical results for Heuristic 7 for n=25, 40,55 where pj

[

5,15

]

...118

5.45. Numerical results for Heuristic 7 for n=25, 40,55 where pj

[

25,35

]

...121

5.46. Numerical results for Heuristic 7 for n=10 where pj

[

1,35

]

...122

(15)

LIST OF TABLES

4.1. Sample calculation of completion times of the trips for Lower Bound 1... 49

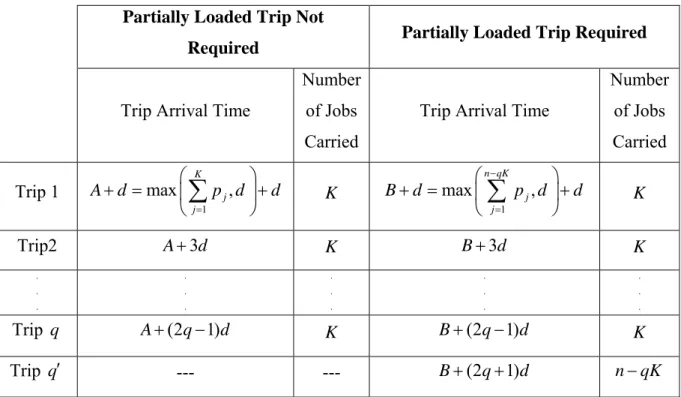

4.2. Trip Completion Times and Number of Jobs Carried in Lower Bound 2... 57

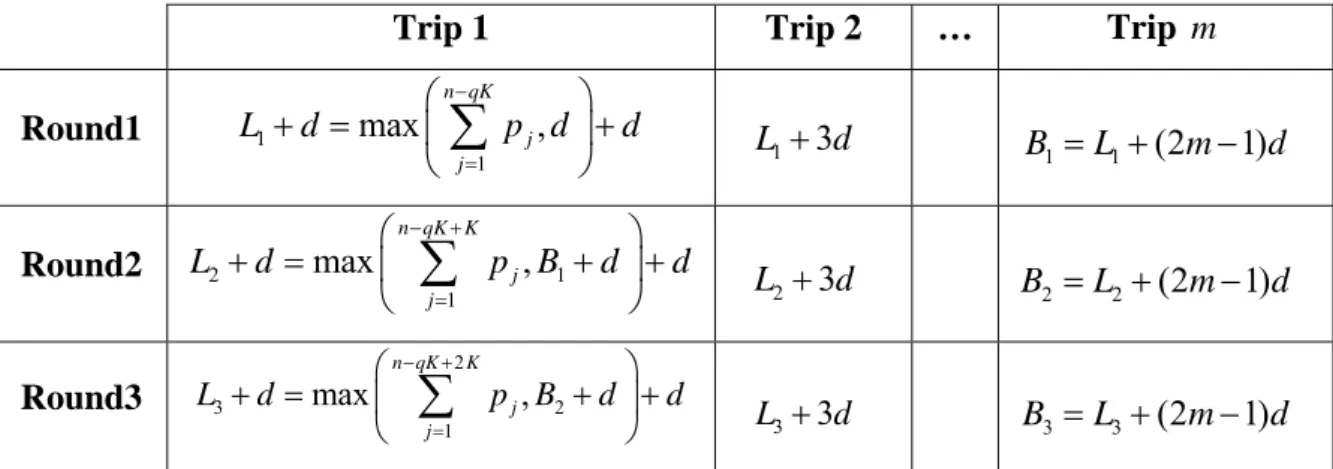

4.3. Trip Completion Times for Lower Bound 3... 58
